To link to this article:
DOI:10.1016/j.compchemeng.2011.04.007
http://dx.doi.org/10.1016/j.compchemeng.2011.04.007
This is an author-deposited version published in:
http://oatao.univ-toulouse.fr/
Eprints ID: 5007
To cite this version:
Fabre , Florian and Hétreux, Gilles and Le Lann, Jean Marc and Zaraté, Pascale
Dynamic hybrid simulation of batch processes driven by a scheduling module.
(2011) Computers & Chemical Engineering, vol. 35 (n° 10). pp. 2098-2112.
ISSN 0098-1354
O
pen
A
rchive
T
oulouse
A
rchive
O
uverte (
OATAO
)
OATAO is an open access repository that collects the work of Toulouse researchers and
makes it freely available over the web where possible.
Any correspondence concerning this service should be sent to the repository
administrator: [email protected]
Dynamic
hybrid
simulation
of
batch
processes
driven
by
a
scheduling
module
Florian
Fabre
a, Gilles
Hétreux
a,∗, Jean-Marc
Le
Lann
a, Pascale
Zaraté
baLaboratoiredeGénieChimique(PSI–GI),UMR-CNRS5503/INPT-ENSIACET,4,alléeEmileMonso,31030Toulouse,Cedex4,France bIRIT/INPT-ENSIACET,118RoutedeNarbonne,31062Toulouse,Cedex9,France
Keywords:
DynamichybridsimulationEnvironment Batchprocesses
Scheduling Petrinets
MixedIntegerLinearProgramming Objectorientedmodeling
a
b
s
t
r
a
c
t
SimulationisnowaCAPEtoolwidelyusedbypracticingengineersforprocessdesignandcontrol.In particular,itallowsvariousofflineanalysestoimprovesystemperformancesuchasproductivity,energy efficiency,wastereduction,etc.Inthisframework,wehavedevelopedthedynamichybridsimulation environmentPrODHySwhoseparticularityistoprovidegeneralandreusableobject-orientedcomponents dedicatedtothemodelingofdevicesandoperationsfoundinchemicalprocesses.Unlikecontinuous processes,thedynamicsimulationofbatchprocessesrequirestheexecutionofcontrolrecipestoachieve asetofproductionorders.Forthesereasons,PrODHySiscoupledtoaschedulingmodule(ProSched)based onaMILPmathematicalmodelinordertoinitializevariousoperationalparametersandtoensureaproper completionofthesimulation.Thispaperfocusesontheprocedureusedtogeneratethesimulationmodel correspondingtotherealizationofascenariodescribedthroughaparticularscheduling.
1. Introduction
For severaldecades,processingand recoveryof raw materi-alshascauseda tremendousexpansionofindustrial chemistry. Iftheunitsinthissectortraditionallyoperatecontinuously,food, biotechnology,pharmaceuticalorelectronicsindustriesare func-tioningpreferentiallyinabatchmode.Indeed,locatedonmarkets subject tohigh turnover of productsand fluctuating or
unpre-dictable demand, batch processes are characterized by these
qualitiesofflexibility.Generallyusedtomanufacturehighadded valueproducts,profitsmadesofarweresuchthatitseemed some-whatinterestingtodeveloptoolsandmethodologiestoimprove theperformanceoftheseunits.Buttheinternationalizationof mar-ketsandthegrowingneedsofsocietyhaveledtonewindustrial strategies.Locatedinhighlycompetitivemarkets,thefunctionof theprocessisthencomplicatedbyadesiretoconsolidate produc-tionfacilitiesandreducecosts.Thesenewconstraintsarereflected todaybyanundeniableinterestofindustrialandscientific commu-nitytobetterdesignandmoreimportantly,tobetterexploitthese batchprocesses.
AmongtheavailableCAPEtools(ComputerAidedProcess Engi-neering), process engineers are showing a growing interest in
dynamicsimulationforitsabilitytocarryoutvariousanalyses (con-figurations,operatingpolicies,etc.)ona“virtual”plant,extremely usefultoprocessengineersin theirdailyworktoimprove
sys-∗ Correspondingauthor.Tel.:+33562883660.
E-mailaddress:[email protected](G.Hétreux).
temperformance(productivity,energyefficiency,wastereduction, etc.).Duringthedevelopmentofanewprocess,massandenergy balances,equipmentssizing,utilitiesneedsassessment,estimation oftimecycleorcostanalysisaregenerallyperformedandthese toolscansignificantlyreducedesignvarianceandthelaboratory workonpilotwhichisoftencostlyandtimeconsuming.In oper-ation,havingareliablesimulationmodelimprovesunderstanding ofthewholeprocessbytheoperatorsandfacilitates communica-tion.Productionengineerscanassessinafewminutestheimpact ofcriticalparametersonkeyindicatorssuchasproductioncosts, timecycle,energyefficiencyorproductivity.Thesimulationalso providesthemeanstomonitortheoccupancyofalltanksduring
acampaignandverifythattheminimumandmaximumloadsare
alwaysmetinallpartsoftheprocess.Itcanvalidateoperating con-ditionsofeachtaskandsetsthecontrolloopsrequiredtomaintain theseoperatingconditions.Finally,inasafetypointofview,the impactofdefaultsintheoperativeorcommandpartcanbequickly estimatedbysimulationandcorrectiveactionscanbetested.
Inthiscontext,theunificationofresearchinmodelingand sim-ulationofprocessescarriedoutformanyyearsintheLGChasledto thedevelopmentofPrODHyS(Fabre,2009;Hétreux,Théry,Perret, Lelann,&Joulia,2002;Jourda,Joulia,&Koehret,1996;Moyse,2000; Olivier-Maget, 2007; Perret,2003; Sargousse,1999), a dynamic
hybridsimulationenvironmentdedicatedtochemicalprocesses

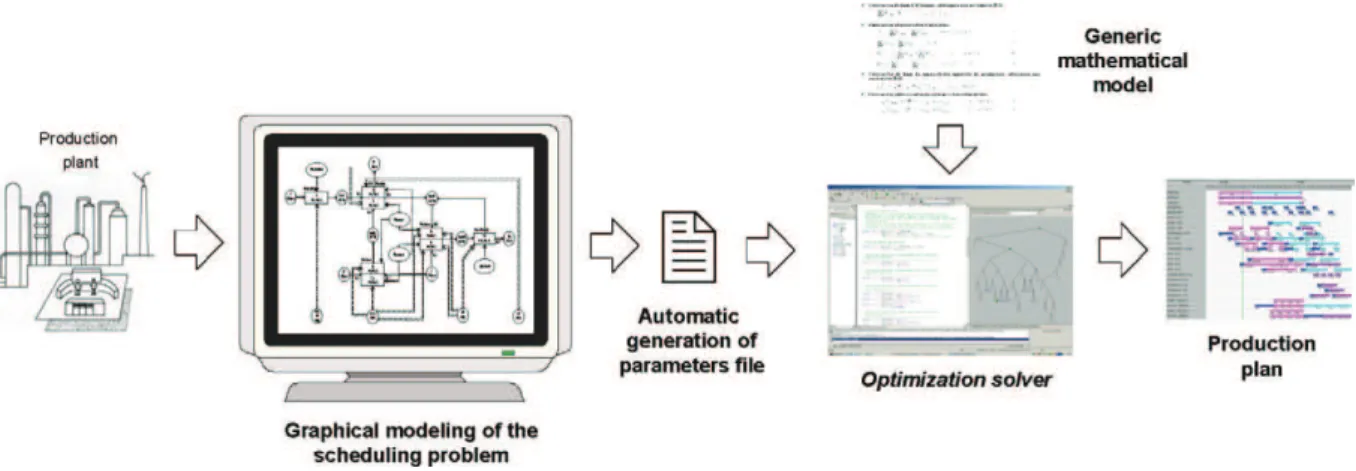

(Fig.1).
Basedonobjectconcepts,thisenvironmentoffersextensibleand reusablesoftwarecomponentsallowingarigorousandsystematic modelingofthetopologyandthebehaviorofprocesses.Thehybrid featureismanagedwiththeObjectDifferentialPetriNets(ODPN)
Nomenclature
Indices
i processingtasks
st storagetasks
j units
n eventpointsrepresentingthebeginningofatask
s states
Sets
I setofprocessingtasksi
ST setofstoragetasksst
STs setofstoragetasksstforstates
Ij tasksithatcanbeperformedinunitj
Is setoftasksithatusestates
Isp setoftasksithatproducestates
Isc setoftasksithatconsumestates
J setofunitsj
Ji setofunitsjthataresuitableforperformingtaski
N setofeventpointsnwithinthetimehorizon
S setofstatess
Sf stateswithfiniteintermediatestorage
Sn stateswithnointermediatestorage
Sp statesthatarefinalproducts
Sr statesthatarerawmaterials
Sz stateswithzero-waitpolicy
Parameters
Vimin,Vimax minimumandmaximumcapacityfortaski
Csmax maximumamountofstatesthatcanbestored
p
i,s/ci,s proportionofstatesproducedorconsumedbytask
i
pfi fixedpartoftheprocessingtimeoftaski
pvi variablepartoftheprocessingtimeoftaski
H maximumdurationofthecampaign→timehorizon
hs storagecostofstates
Ds amountofstatesdeliveredattheendofthe
cam-paign
Variables
Bi,n amountofmaterialundertakingbytaskiatevent
pointn
Bsi,n amountofmaterialstartingprocessingbytaskiat
eventpointn
Bfi,n amountofmaterialfinishingprocessingbytaskiat
eventpointn
Bstst,n amountofmaterialstoredbystoragetaskstatevent
pointn
Ss,n amountofstatesateventpointn
SFs finalamountofstatesattheendofthetimehorizon
S0s initialamountofstatesatthebeginningofthetime
horizon
Tsi,n timeatwhichtaskistartsateventpointn
Tfi,n timeatwhichtaskifinishesateventpointn
pti,n processingtimeoftaskiateventpointn
Tsstst,n timeatwhichstoragetasksststartsateventpointn
Tfstst,n timeatwitchstoragetasksstfinishesateventpoint
n
Wi,n 1iftaskiisactivatedateventpointn,else0
Wsi,n 1ifthetaskibeginsateventpointnelse0(binary
variable)
Wfi,n 1ifthetaskiendsateventpointnelse0(binary
variable)
Plan durationoftheproductionscheduling
Table1
Batchmanagementwithoptimizationordynamicsimulationapproach. Optimisationmethod Dynamicsimulation Advantages Exhaustiveexplorationof
candidatesolutions
Morerealisticmodelingof processes
Globalconsiderationofall theconstraints
Processingtimes determinedby
phenomenologicalmodels Efficientsolvingmethod
Drawbacks Modelingoftenbasedon simplifyingassumptions, whichdonotpermitto exploittheentireflexibility oftheprocess
Evaluationofacandidate solution simulationof theprocessforagiven sequenceandagivenbatch sizes limitedexploration ofcandidatesolutions Fixedandoften
overestimatedprocessing times
Myopicview difficulties totakeintoaccounttime constraints(no-wait,
conditioningcalendar, cleaningpolicy)
formalism.Itcombines inthesamestructure, asetof
differen-tialand algebraic equations (DAE) systems which describe the
continuousevolutionofthesystem(primarilybasedonthe
ther-modynamicandphysicochemicallaws)andhighlevelPetrinets
whichdefinethelegalcommutationsequencesbetweenstates(i.e. oneofthepossibleconfigurationsofDAEsystems).
Nevertheless,inoppositetocontinuousprocesses,studieson batchunitsoftennecessitatetotakeintoaccountboththe physic-ochemicalphenomenathattakeplaceineachdevice(localvision)
andthemanagementofbatches(nature,size,numberandstarting date)passingthroughtheunit(globalvision).Obviously,thesetwo featureshaveasignificantimpactontheperformancesandinduce thatthesystemhastobetackledasawholetoestablishaconsistent analysis.Inthiscontext,thesimulatormustbeabletoruna sce-nariodescribedbyaproductionplanincludingproductionorders (PO),eachPOindicatingamongotherthings,thetypeofproduct, thequantitytobeproducedandtheperiodofexecution(starting andendingdateofthejobs).
Toachievetheproductionplanandmeetthevariousconstraints, atemporalandquantitativesynchronizationmustbeensured.But,
themanagementofbatchesonlybysimulationdoesnotalways
givesatisfactoryresultsandmayevenleadtoabortanexecution. First,inordertotakeintoaccountthecapacityofequipment,itis oftennecessarytosplitproductionordersintoseveralbatches.The numberandsizeofthesesbatcheshavetobecalculated.In addi-tion,themyopicviewofthesimulationpreventsaproperhandling of time constraints(delivery dates, zero-wait policy,maximum delay,etc.),resourceallocationconstraintsorcleaningconstraints. Inmanydynamicsimulators,thesecalculationsareeitherassumed bytheuser,eitherbasedonheuristicsorsimplepriorityrules.So, inordertotacklerigorouslyeachpartoftheproblemandimprove thesolutions,thestrategyadoptedinPrODHySconsistsindriving thesimulationbyfollowingaproductionscenarioobtainedfrom
aschedulingmodulebasedonoptimizationtechniques.Table1
summarizedthemaincharacteristicsofthesetwokindsoftool. Thepurposeofthispaperistopresentthetoolsand method-ologiesusedtoimplementtheinterfacebetweenthisscheduling moduleandthesimulationmodel.Therestofthepaperisorganized asfollow.InSection2,theproblemstatementandtheprinciple oftheproposedapproacharedescribed.Eachmoduleofthistool isthen describedin thefollowing order.In Section3,theERTN
graphicalformalismisbrieflypresentedandillustrated.Section4
describestheimplementedmathematicalformulation.Section5
presentsthemajorconceptsonwhichthedynamichybrid
simu-latorisbased.Finally,Section6dealswiththecommandlevelof thesimulationmodelandithighlightsthenecessityofcoupling
Fig.1.PackagesofthedynamichybridsimulationenvironmentPrODHyS.
thesimulatorwitha schedulingmodule.Theinterfacewiththe simulatoristhenpresentedandsomeremarksarediscussed. 2. Mainstepsoftherecipe-drivendynamichybrid simulation
2.1. Generalfeaturesoftheconsideredbatchprocesses
The addressed processes are multi-purpose batch or
semi-continuousplant.Inthiskindofunit,eachproductfollowsaspecific sequenceofoperationsandisproducedusingsharedprocessing equipment.Thesegeneralnetworkprocessescorrespondtothemore generalcaseinwhichbatchescanbemergedand/orsplit.This fea-tureinducesthatmaterial balancesmustbetakenintoaccount explicitly (inopposite tosequential processes that areorder- or batch-orientedanddonotrequiretheconsiderationofmass bal-ances).Consequently,thecorrespondingsimulationmodelshave toincorporateseveralgeneralcharacteristicsthatinclude: •disjunctive(devices,operators,etc.)andcumulative(materials,
utilities,etc.)resourcesconstraints,
•variousstorageandtransferpolicies(UIS:UnlimitedIntermediate Storage,FIS:FiniteIntermediateStorage,NIS:NoIntermediate Storage,ZW:Zero-Wait,etc.)
•fixedand/ordependentprocessingtimes(dependingonbatch
size),
•mixingandsplittingofbatches,inducingvariablebatchsizealong theproduction
2.2. Modelingofrecipes
Recipeisanentitythatdescribestheformulation(setof chem-ical substances and proportions),the procedure(set of physical stepsrequiredtomaketheproduct)andtherequiredequipment.
Totacklecomplexprocesses,thestandardISA/SP88(www.isa.org) hasspecifiedahierarchicalmodelincluding4levels(Fig.2),each oneprovidinginformationinanappropriategranularity:
•Generic(orgeneral)recipespecifiesthemanufacturingmethodof eachfinishedproduct.Itcontainsinformationaboutthe
mate-Fig.2.Hierarchicalmodelingoftherecipe.
rials(rawmaterialsandintermediates),proportions,operating parameters,but,nodataabouttheequipmentoftheproduction systemisprovided.
•Siterecipeisaninstantiationofthegenericrecipeinwhichthe detailsabouttheproductionsiteareincorporated.Thisinvolves thegeneraltopologyoftheprocessandcleardefinitionsofthe characteristics of theprocessing equipment(capacity, energy consumption,etc.).
•Masterrecipeisaninstantiationofthesiterecipethatsetsthetype andamountoffinishedproduct(s)tobeproducedinagiven oper-ationalhorizon.Itthereforeclarifiestheproductionorderstobe achieved.Thislevelofrecipemakesuseofscheduling,which cal-culatesthenumberandsizeofeachbatchaswellasthesequence ofthesebatchesonequipment.
•Controlrecipeisappliedtoaparticularbatchorlotanddescribes theexecutionofeachtaskindetail.Itisimplementedata super-visionlevel.
2.3. Graphicalframeworkforthemodelingofrecipes
Tofacilitatethemodelingphasebynon-expertusersin
opti-mization and simulation, a way is to build optimization and
simulationmodelswhicharestructurallygenericandconfigurable
withparameters entered through a well-defined graphical
for-malism.Indeed,theimplementationandthetuningofaMILPor
simulation model can becomerather technical and complex in
somecases.Thus,thesupportofavisualrepresentationcanbevery helpfulforthemodelingoftheproductionsystem.Providedthat thesemanticofthisgraphicalformalismissufficientlygeneral,it allowstheusertodescribeaprobleminasimpleandintuitiveway whileignoringthemathematicalsupportusefultoitsresolution. Anotheradvantageofsuchformalismistheabilityto unambigu-ouslymodela problembyaddingspecific constructionrules.It reduces(butitdoesnotavoid)potentialmodelingmistakesand
userscanspendmoretime inanalysingthesystemratherthan
developingthemodel.
Inthisframework,theExtendedResourceTaskNetwork(ERTN) formalismhasbeendevelopedforthemodelingofrecipes.Basedon
thewell-knownResourceTaskNetwork(RTN)formalismproposed
in(Agha,2009;Fabre,2009;Pantelides,1994)haveintroducednew semanticelements(seeSection3)notablyamongothers,inorderto handleexplicitlycumulativeresources(suchasutilitiesfor exam-ple)andmulti-modalresources.Intheseworks,theERTNformalism ismorepreciselyusedtomodeltheprocedurepartofthesiterecipe.
Itisconstructedfromtheprocedureofthegenericrecipeandthe topologyoftheunitchosentoexecutethisrecipe.

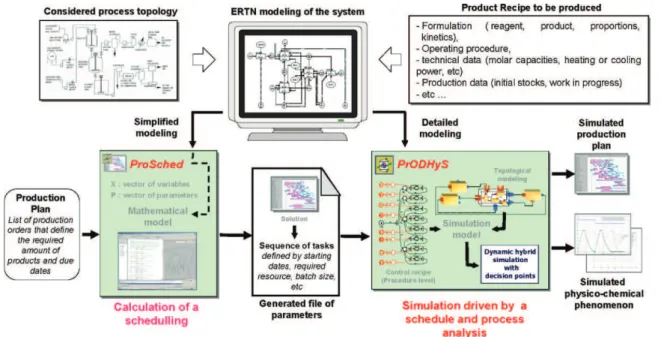

2.4. Mainstepsofthedynamicsimulationprocedure
Fig.3showsaschematicdiagramoftheprocedureimplemented torunadynamicsimulationofacompleteprocessforagiven pro-ductioncampaigninPrODHyS.
Giventhegenericrecipeofthemanufacturedproductsandthe topologyoftheunit,theprocedureofthesiterecipeismodeledin ourtoolusingtheERTN(ExtendedResourceTaskNetwork)graphical formalism.
Tomanageoverallflows passingthroughtheunit, a
“simpli-fied”butstructurallygenericschedulingmodelbasedona MILP
formulationissetandinstantiatedwithdataprovidedthroughthe
ERTNview(setofestimatedparametersforduration,capacityof devicesaccordingtothestoredmaterial,etc.).Thus,givenatime horizonanda productionplan(obtainedbyaMRPprocedurefor example),thepackageProSchedcalculatesaschedulingbycalling thecommercialsolverXPRESS-MPforagivencomputationeffort. Thistreatmentgivesrisetothemasterrecipeandtheresultinglist oftaskscanbedepictedonaGanttchart.Datacharacterizingeach taskaretransmittedviaafiletothedynamicsimulatorPrODHySin ordertoparameterizethecommandlevelofthesimulationmodel (i.e.thecontrolrecipe),previouslyconstructedinaccordancetothe
ERTNviewbyassemblingpredefinedoperationobjects.Theprocess levelofthesimulationmodelisbuiltaccordingtothetopologyof theunitwithdeviceorcompositedeviceobjects.Thesimulationof this“detailed”modelisthenexecuteduntilthecompletionofthe productionplan.
Anormallyendedsimulationindicatesthatallcapacityandtime constraintsaremet.Theproductionplanisvalidatedandthe analy-sisoftheoperationalandphysicochemicalpropertiescanbemade. Ifasimulationfailsthenitmeansthatconstraintsareviolatedand theuserhastoanalyzethesimulationresults(viatheevaluationof variousindicators)toundertakecorrectiveactions.Nevertheless, accordingtotheobjectiveofthestudy,someparametersofthe (simplifiedand/ordetailed)modelmaybemodifiedorrefinedby exploitingthesimulationofthepreviousiteration.Thisprocedure canberestarteduntiltheuserfindssatisfactoryresults.
Insummary,themainideaofthiscombinedapproachistotake advantageofthestrengthsofdynamicsimulationand mathemati-calprogrammingtoachieveaconsistentbatchmanagementinthe
workshopandthus,toenhancetheachievementofthedynamic
simulation.
3. TheERTNgraphicalformalism
3.1. BriefdescriptionoftheERTNformalism
Theexpressivequalityofformalismisjudgedbyitsaptitudeto summarizeonasinglegraphtheinformationnecessaryto repre-sentaprocess.Inthiscontext,StateTaskNetwork(STN)proposed by(Kondili,Pantelides,&etSargent,1993)hasbeenafirststep towarddeveloping a universalrepresentationfor abatchplant. Later,(Pantelides,1994)hasproposedtheResourceTaskNetwork
(RTN)formalism,anextensionoftheSTNthatcontainsmore infor-mationaboutprocessingequipmentandtheirconnectivity.Based uponthemajorconceptsofthewell-knowRTNformalism(Agha, 2009;Fabre,2009)haveintroducednewsemanticelementsand theresultingframeworkiscalledExtendedResourceTaskNetwork
(ERTN). Thus, this graph represents the main features
encoun-teredinbatchprocesses.Theunderlyingsemanticelementsare listedinFig.4.Accompaniedbywell-establishedconstructionrules,
it clearlyand unambiguouslyrepresents production procedures
(precedenceconstraints),materialsandenergyflows(ratioofinlet andoutletflows,freeflows,recycling,separation andmixingof batches) andresource constraints(topology ofunit, capacity of devices,fixedordependentoperatingtime,sharedandmultimodal devices,etc.).ThegenericnatureoftheERTNformalismoffers a directcorrespondencebetweenthegraphicalelementsand mathe-maticalconstraints.So,severalformulationscanbeassociatedwith
theERTNframework.
3.2. Exampleofbatchprocessmodeling
Toillustratea subpartoftheERTNsemantic, atypicalbatch processispresented.Inthisexample,theproductionoftwofinal productsisconsidered.ProductP1necessitatesthreesuccessive operations:a preheatingofreactantA, nexta reaction(reaction
1:A+B→IntAB)andfinally,adistillationtoseparatefinal
prod-uct P1 and residue P2. If we suppose that intermediate IntAB
alreadyexists,therecipeofproductP3iscomposedoftwo oper-ations:apreheatingofreactantC,followedbyareaction(reaction
2:C+IntAB→P3).

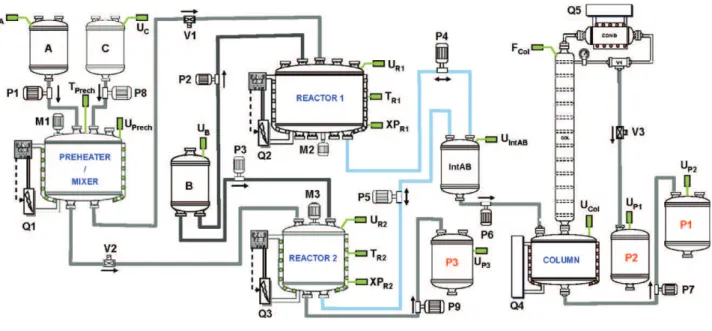

Thetopology of theunit is shown in Fig.5.It consists of a
preheater/mixer,tworeactors(calledREACTOR1andREACTOR2),
acolumn(ensurestheseparationofreactionproducts)and sev-eralstoragetanks(forrawmaterialsA,B,C,intermediateproduct IntAB,residueproductP2andfinalproductsP1,P3).Tocontrol thesedevices,theunitisequippedwithseveralactuators(pumps Pi,valvesVi,heatingsystemsQi,electricmotorsMi)andsensors (retentionUi, temperatureTi, composition XPi, flow Fi). REAC-TION1canbeperformedindifferentlyinthetwo reactorswhile
Fig.3.GeneralprocedureofadynamicsimulationinPrODHyS.
Fig.5.Topologyoftheunit.
regardingtheenergypointofview,reactorsandheaterconsume electricitytomaintaintheoperatingconditionsandthecolumn requireshighpressuresteam(HP)atboilerandacoolant(CW)at condenser.

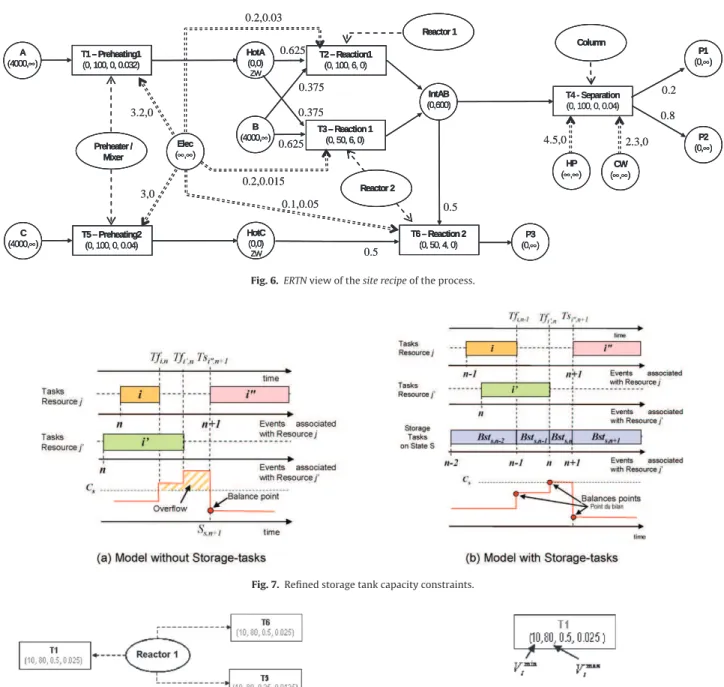

In these conditions, theprocedure of the site recipe is then
modeled by the ERTN shown in Fig. 6. The capacity of tanks
is given in kg and the processing times include a fixed and a
variable (dependent of batch size) part. The absence of
stor-age tankbetween thepreheater and reactors induces that the
stateHotAhasa“capacity”equaltozeroandazero-wait trans-ferpolicy.Moreover,notethatdevices aredisjunctiveresources whilethedifferentkindsofenergyareconsideredascumulative resources.
4. MILPformulationoftheschedulingproblem
4.1. Keyfeaturesoftheconsideredschedulingmodel
Differentmethodsareproposedintheliteraturetosolvethese
problemsrecognizedasNP-complex.Givenourgoal,anymethod
allowingthesimultaneousdeterminationofthestartingdateand thebatch-sizeofeachtaskisacandidate,providingthatagood solutionisobtainedinareasonabletime.So,thequalityoftheplan andtheprovidedcomputationaleffortareparametersforwhich acompromisemustbefound.Severalexcellentreviews(Burkard &Hatzl,2005;Floudas&Lin,2004;Kallrath,2002;Méndez,Cerdá, Grossmann,Harjunkoski,&Fahl,2006)clearlypointoutthatMixed IntegerLinearProgramming(MILP)hasbeenwidelyusedfor
solv-ing the batch process scheduling problem. In this framework,
variousformulationsoftheproblemareproposedinthe litera-ture(Kondilietal.,1993;Maravelias&Grossmann,2003).Globally, wecandistinguishMILPmodelsbasedondiscretetimeformulation (suchasGlobaltimeintervals)orbasedoncontinuoustime formu-lation(suchasGlobaltimepoints,Unit-specifictimeevent,Time slots,Unit-specificimmediateprecedence,Immediateprecedence, Generalprecedence, etc.).In our study,the bestsuited models
regarding the combination of optimization and simulation are
thosebasedonacontinuous-timeformulation.Adetailed compar-isonofthesecontinuous-timemodelscanbefoundin(Shaiketal., 2005).Notably,itpresentsthroughseveralexamplesofbenchmark thegoodcompromiseoftheUnitSpecificEventformulationinterm ofresolutiontimeandrobustness.
4.2. Descriptionoftheoptimizationmodel
Originally,theUnitSpecificEventformulationhasbeen devel-oped by (Ierapetritou & Floudas, 1998). This continuous-time formulationforshort-termschedulingintroducestheoriginal con-ceptofeventpoints,whichareasequenceoftimeinstanceslocated alongthetimeaxisofaunit,eachrepresentingthebeginningofa taskortheutilizationoftheunit.Thelocationoftheeventpoints isdifferentforeachunit,allowingdifferenttaskstostartat dif-ferenttimesin eachunitfor thesameeventpoint. Thetimings oftaskarethen accountedforthrough specialsequencing con-straints.Becauseoftheheterogeneouslocationsoftheeventpoints fordifferentunits,aswellasthedefinitionofaneventasonlythe startingofatask,forthesameschedulingproblem,thenumberof eventpointsrequiredissmallerthanotherscontinuous-time for-mulationsandsubsequently,reducesnotablythenumberofbinary variables.
ThemodelcurrentlyimplementedinProSchedcorrespondsto theformulationfoundin(Janak,Lin,&Floudas,2004)witha lim-iteduseof“BigM”constraintsandtheaggregationof sequence constraints.Moreover,thecapacitylimitsofstoragetankaretaken
into accountpartially by the mathematicalmodel described in
(Ierapetritou&Floudas,1998).Indeed,thematerialbalancesare calculatedonlyatthebeginningoftasks.Insomecases,thiscan locallyleadtooverflowthecapacityofstoragetanks(Fig.7a). How-ever,thatis unacceptablein termsof simulationsince physical constraintsareviolated.
Thus,additionalconstraintshavebeenimplementedby(Janak etal.,2004)totacklethisfeature.Forthis,storagetasksaredefined.
Thesequence andtimingofthesenewtasksandtheprocessing
tasksarethenrelatedsothattheamountsofstateswillbe consis-tentandspecifiedlimitscanbeenforced(Fig.7b).
Notehoweverthatinourformulation,thevariablesareonly
indexedby a eventnumber n and a taskithat correspondsto
a couple (operation, EquipementUnit) and not by anoperation
i,a devicejand eventnasin (Janak etal.,2004).Thisreduces thenumberof variablesand itis consistentwiththeERTN for-malism.AsdescribingindetailthewholeMILPmodelisnotthe aimofthispaper,only thefundamental equationsarereported belowgroupedbyfunctions(forexample,utilityconstraintsarenot givenherealthoughtheyareincludedinourmodel).An exhaus-tivedescriptionoftheseconstraintscanbefoundin(Janaketal., 2004).
A (4000,∞) B (4000,∞) HotA (0,0) ZW P2 (0,∞) Preheater/ Mixer T1 –Preheating1 (0, 100, 0, 0.032) T2 –Reaction1 (0, 100, 6, 0) T4 -Separation (0, 100, 0, 0.04) Reactor1 Column 0.625 0.375 IntAB (0,600) P1 (0,∞) 0.2 0.8 T3 –Reaction1 (0, 50, 6, 0) 0.625 0.375 C (4000,∞) HotC (0,0) ZW T5 –Preheating2 (0, 100, 0, 0.04) T6 –Reaction2 (0, 50, 4, 0) 0.5 Reactor2 P3 (0,∞) 0.5 HP (∞,∞) CW (∞,∞) 4.5,0 2.3,0 Elec (∞,∞) 3,0 3.2,0 0.2,0.03 0.2,0.015 0.1,0.05 A (4000,∞) A (4000,∞) B (4000,∞) B (4000,∞) HotA (0,0) ZW HotA (0,0) ZW P2 (0,∞) P2 (0,∞) Preheater/ Mixer Preheater/ Mixer T1 –Preheating1 (0, 100, 0, 0.032) T1 –Preheating1 (0, 100, 0, 0.032) T2 –Reaction1 (0, 100, 6, 0) T2 –Reaction1 (0, 100, 6, 0) T4 -Separation (0, 100, 0, 0.04) Reactor1 Reactor1 Column Column 0.625 0.375 IntAB (0,600) IntAB (0,600) P1 (0,∞) P1 (0,∞) 0.2 0.8 T3 –Reaction1 (0, 50, 6, 0) T3 –Reaction1 (0, 50, 6, 0) 0.625 0.375 C (4000,∞) C (4000,∞) HotC (0,0) ZW HotC (0,0) ZW T5 –Preheating2 (0, 100, 0, 0.04) T5 –Preheating2 (0, 100, 0, 0.04) T6 –Reaction2 (0, 50, 4, 0) T6 –Reaction2 (0, 50, 4, 0) 0.5 Reactor2 Reactor2 P3 (0,∞) P3 (0,∞) 0.5 HP (∞,∞) HP (∞,∞) CW (∞,∞) CW (∞,∞) 4.5,0 2.3,0 Elec (∞,∞) Elec (∞,∞) 3,0 3.2,0 0.2,0.03 0.2,0.015 0.1,0.05
Fig.6.ERTNviewofthesiterecipeoftheprocess.
Fig.7.Refinedstoragetankcapacityconstraints.
Fig.8. Allocationconstraints(disjunctiveresources).
Thenomenclatureassociatedwiththis modelisgiveninthe appendixattheendofthearticle.Onthebasisofthisnotation,the mathematicalmodelinvolvesthefollowingconstraints:
Allocationconstraints(cf.Fig.8):
X
i∈Ij Wi,n≤1∀
j∈J,∀
n∈N (A.1) Wi,n=X
n′≤n Wsi,n′−X
n′<n Wfi,n′∀
i∈I,∀
n∈N (A.2)X
n∈N Wsi,n=X
n∈N Wfi,n∀
i∈I (A.3) Wsi,n≤1−X
n′<n Wsi,n′+X
n′<n Wfi,n′∀
i∈I,∀
n∈N (A.4) Wfi,n≤X
n′≤n Wsi,n′−X
n′<n Wfi,n′∀
i∈I,∀
n∈N (A.5)Fig.9.Capacityconstraintsofprocessingtasks.
CapacityconstraintsandBatch-sizematchingconstraintsof Pro-cessingTasks(cf.Fig.9)
Vmin
i Wi,n≤Bi,n≤VimaxWi,n
∀
i∈I,∀
n∈N (A.6)Bi,n≤Bi,n−1+Vimax(1−Wi,n−1+Wfi,n−1)
∀
i∈I,∀
n∈N|n>1(A.7)Bi,n≥Bi,n−1−Vimax(1−Wi,n−1+Wfi,n−1)
∀
i∈I,∀
n∈N|n>1(A.8)Bsi,n≤Bi,n
∀
i∈I,∀
n∈N (A.9)Bsi,n≤VimaxWsi,n
∀
i∈I,∀
n∈N (A.10)Bsi,n≥Bi,n−Vimax(1−Wsi,n)
∀
i∈I,∀
n∈N (A.11)Bfi,n≤Bi,n
∀
i∈I,∀
n∈N (A.12)Bfi,n≤VimaxWfi,n
∀
i∈I,∀
n∈N (A.13)Bfi,n≥Bi,n−Vimax(1−Wfi,n)
∀
i∈I,∀
n∈N (A.14)Capacityconstraintsofstoragetasks
Fig.10.Materialbalancesonstate.
Fig.11.Durationofprocessingtasks.
MaterialBalancesincludingStorageTasks(cf.Fig.10) Ss,n=Ss,n−1+
X
i∈Is pi,sBfi,n−1−X
i∈Is c i,sBsi,n+X
st∈STs Bstst,n−1 −X
st∈STs Bstst,n∀
s∈S,∀
n∈N|n>1 (A.16) Ss,1=S0s−X
i∈Is c i,sBsi,1−X
st∈STs Bstst,1∀
s∈S (A.17) SFs=Ss,N−Ds+X
i∈Is pi,sBfi,N+X
st∈STs Bstst,N∀
s∈S, (A.18) Ss,n≤Cs∀
s∈S,∀
n∈N (A.19) Ss,n=0∀
s∈Se∪Sf∪Sn,∀
n∈N (A.20)DurationconstraintsofProcessingtasks(cf.Fig.11)
Tfi,n≥Tsi,n
∀
i∈I,∀
n∈N (A.21)Tfi,n≤Tsi,n+MWi,n
∀
i∈I,∀
n∈N (A.22)Tsi,n≤Tfi,n−1+M(1−Wi,n−1+Wfi,n−1)
∀
i∈I,∀
n∈N|n>1(A.23)pti,n=pfiWsi,n+p
v
iBsi,n∀
i∈I,∀
n∈N (A.24)Tfi,n′ −Tsi,n≥pti,n−M(1−Wsi,n)−M(1−Wfi,n′)
−M
X
n≤n′′<n′
Wfi,n′′
∀
i∈I,∀
n∈N,∀
n′∈N,n≤n′ (A.25)Tfi,n′ −Tsi,n≤pti,n+M(1−Wsi,n)+M(1−Wfi,n′)
+M
X
n≤n′′<n′
Wfi,n′′
∀
i∈/Ips,∀
n∈N,∀
n′∈N, n≤n′ (A.26)DurationConstraintsofStorageTasks
Tfstst,n≥Tsstst,n
∀
st∈ST,∀
n∈N (A.27)Sequenceconstraintsofprocessingtasks:sametaskinthesame unit
Tsi,n≥Tfi,n−1
∀
i∈I,∀
n∈N|n>1 (A.28)Sequence constraintsof processingtasks: different tasksin the
sameunit
Tsi,n≥Tfi′,n−1+i′,i−M(1−Wfi′,n−1−Wsi,n)
∀
j∈J,∀
i∈Ij,∀
i′∈Ij|i=/i′,∀
n∈N|n>1 (A.29)Sequenceconstraintsofprocessingtasks:differenttasksindifferent units
Tsi,n≥Tfi′,n−1−M(1−Wfi′,n−1)
∀
s∈S,∀
i∈Isc,∀
i′∈Isp,∀
j∈Ji,∀
j′∈Ji′|j=/j′,∀
n∈N|n>1 (A.30)Sequenceconstraintsofprocessingtasks:no-waitcondition(ZW transferpolicy)
Tsi,n≤Tfi′,n−1+M(2−Wfi′,n−1−Wsi,n)
∀
s∈Sz∪Sn∪Sf,∀
i∈Isc,∀
i′∈Ips,∀
j∈Ji,∀
j′∈Ji′|j=/j′,∀
n∈N|n>1(A.31) Sequenceconstraintsofstoragetasks
Tsi,n≥Tfstst,n−1
∀
s∈S,∀
i∈Izc,∀
st∈STs,n∈N|n>1 (A.32) Tsi,n≤Tfstst,n−1+M(1−Wsi,n)∀
s∈Sf,∀
i∈Icz,∀
st∈STs, n∈N|n>1 (A.33) Tsstst,n≥Tfi′,n−1−M(1−Wfi′,n−1)∀
s∈S,∀
i′∈Isp,∀
st∈STs, n∈N|n>1 (A.34) Tsstst,n≤Tfi′,n−1+M(1−Wfi′,n−1)∀
s∈Sf,∀
i′∈Ips,∀
st∈STs, n∈N|n>1 (A.35) Tsstst,n=Tfstst,n−1∀
st∈STs, n∈N|n>1 (A.36) Boundconstraints Tfi,n≤H∀
i∈I,∀
n∈N (A.37a) Tsi,n≤H∀
i∈I,∀
n∈N (A.37b) 0<Wi,n<1∀
i∈I,∀
n∈N (A.38)Plandurationconstraint:
Tfi,n≤Plan
∀
i∈I,∀
n∈N (A.39)Objectivefunction min a. Plan+
X
s∈S hsSFs+X
s∈SX
n∈N hsSs,n!
(A.40)4.3. ComplementarytoolsdevelopedforProSchedmodule
Asmentioned previously,anysemanticelementofERTN for-malismdescribedinSection3hasadirecttranslationwithsets ofconstraintsofthemathematicalmodel.Thisgivesthegeneric natureofthismodelsinceeachprobleminstanceissimplydefined throughadatafile(Fig.12).
Inordertofacilitateparametersentry,a“draganddrop”tool hasbeendeveloped.TheusercancreateitsERTNgraphicallyand choosealltheparameters(units,tasks,durations,sequences...) ofitsmodel.Afteranautomaticverificationofthevalidityofthe
ERTN,theprogramcreatestheinitializationfilecompatiblewith themodelofoptimizationimplementedinXpressMP.
Aftertheschedulingphase,theusercanproceeddirectlytoa firstanalysisbasedonGanttdiagram.Asecondtoolcaninterpret directlythedataprovidedbytheoptimizeranddisplayitasaGantt chartwiththeevolutionofamountofstatesandbatchesonthetime horizon(seeFig.13).
Fig.12.Toolsassociatedtothefirststepoftheprocedureofdynamicsimulation.
Fig.13. ProSchedGeneratorandGanttChartManager.
5. ThedynamichybridsimulatorPrODHyS
This section presents briefly themain characteristicsof the dynamicsimulatorPrODHySandthen,describesthestructureof thesimulationmodel,andespeciallythecommandlevel.
5.1. TheODPNformalism(ObjectDifferentialPetriNet)
Batchprocessesaregenerallyclassifiedasdynamichybrid sys-tems(Zaytoon,2001).Thiskindofsystemrequiresspecificdynamic simulatorsabletohandlerigorouslyboththecontinuousevolution ofthestatevariables(temperatureincrease,chemicalkinetics,etc.) andthediscretebehavior(on/offpump,open/closevalve,etc.).In thisframework,theplatformPrODHySusestheObjectDifferential PetriNetformalism(ODPN)tomodelthehybridbehaviorofboth devicesandmaterialitcontains.Fig.14recallsthesemantic ele-mentsofODPN.Theformaldefinitionandevolutionrulesofthis formalismanditsimplementationwithinPrODHySaredescribedin detailin(Perret,2003)andpresentedin(Hétreux,Perret,&LeLann,
2003;Hétreux,Thery,Olivier,&LeLann,2007;Perret,Hétreux,& LeLann,2004;Hétreux,Perret,&LeLann,2004).
5.2. Generalstructureofthesimulationmodel
To make the simulation of a discontinuous process, it is
necessary to model both the control part (the supervisor) and
the operative part (the process). In PrODHyS, the simulation
model located at the command level (presumably specific to
the recipe, the topology of the considered process and the
production plan to achieve) is completely separated from the
simulation models of devices. Indeed, models of devices must
be reusable regardless of the context (concept of component).
Thus, differentrecipescanbe implementedand testedwithout
changingthemodelsassociatedwiththedevices(i.e.theprocess
level).
ThemodelofthecommandlevelisthemasterODPN(calledrecipe PetriNet)whoseevolutioncauseschangesintheODPNofthe enti-tieslocatedattheprocesslevel.ThisODPNcorrespondssomehowto

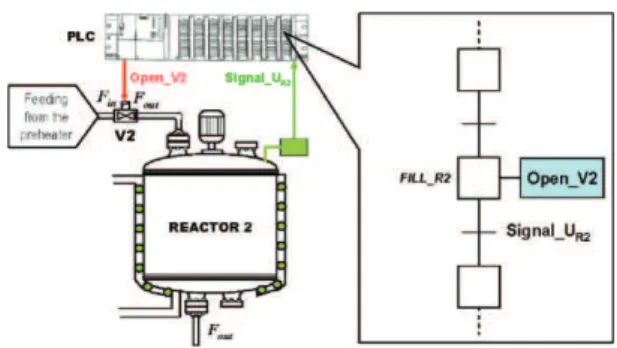

Fig.15. SubpartoftheprocessshowninFig.4andGRAFCETsequence.
thecontrolrecipeorGRAFCETprogramexecutedbyaProgrammable LogicController(seeexampleinFig.15).
The signals exchanged between the command part and the
process section correspondeither to transmit a command (sig-nalOpen V2),ortoreceiptaninformationfromasensor(signal SignalUR2).A signalismodeled bya place(called respectively, commandorinformationplace)anditsstatusisassociatedwiththe markingofthisplace.Theseplacesaretheuniquelinkbetween
processandcommandlevels.
Regardedasblack boxes, thereare twotypes ofdevice (see
Fig.16):
•activedevices:objectswhosePetrinethasoneormorecommand and/orinformationplacessuchasactuators(cf.VALVEV2)and
sensors(seeCAPTORUR2)
•passivedevices:objectswhosePetrinethasnodirectlinkwith therecipePetrinetsuchastanks,reactors(seeREACTOR2)or material.
Themarkingofacommandplaceofanactivedeviceinduces gener-allychangesinitsownPetrinet,itselfcausingevolutionincascade inpassivedevicesthroughthenetworkformedbytheconnectionof thevariousmaterialorenergyports.Inconsequence,theevolution ofODPNmodelsisconditionedbytwodistincttypesofevent: •first,theexternaleventsthatcausecontrolledswitching.These
eventsare issuedfromtherecipePetrinettodrive theactive
devicesoritistheoccurrenceofastateevent(threshold)ora tem-poralevent.Specifiedbytheuser,theseeventsappearexplicitly ontherecipePetrinet.
•secondly,theintrinsiceventswhoseoccurrencedependsonlyon
thespontaneousevolution ofthe process.These autonomous
switchesareforexample,achangeinmaterialstate(the transi-tionfromliquidtoliquid/vaporwhentheboilingpointisreached)
or a commutationin a passivedevice. Theytherefore do not
appearexplicitlyintherecipePetrinet(theuserdoesnothave tospecifythem)andaretreatedsolelywithinthemodelofthe entity.
InteractionsbetweenrecipePetrinetandprocessPetrinetare illus-tratedinFig.16.Thisisthetranslationofthesystemshown in
Fig.15anditrepresentsanoperatingsequenceinwhichareactor isfeduntilafixedvolumeisreached.Thefillingoperationis con-trolledbytherecipePetrinetbyplacingatokenonthecommand
placeofthevalveobject(placeOpenV2).Thefeedofreagentis keptopenwhilethiscommandplaceismarked.Todetectthe end-ingtimeofthetransfer,aleveldetectorobjectisused.Themarking oftheinformationplace(placeSignalD1)oftheleveldetectorobject indicatesthatthevolumeofreagenthasreachedthetargetvalue. Thetransitionisfired.Theabsenceoftokenonthecommandplace thencausestheclosureofthevalveobject.Inthefollowing,only
recipePetrinetisshown(sequenceofoperations)andequipment areseenonlythroughtheirsignalplaces.
6. Drivingadynamichybridsimulation
6.1. Hierarchicalmodelingoftherecipe
TherecipePetrinetisthelinkbetweentheoptimizationmodel
andthesimulationmodeloftheoperativepart.However,when
theproductionsystemincludesextensivefacilitiesortheproduct developmentrequiresmanyoperations,thesizeofODPN associ-atedwiththecommandlevelcangrownquickly.Inthiscase,itis necessarytostructurethecontrolrecipeinsuccessiverefinements.
6.1.1. Notionofparameterisedmacro-place
Based on the decomposition advocated by the ISA-SP88

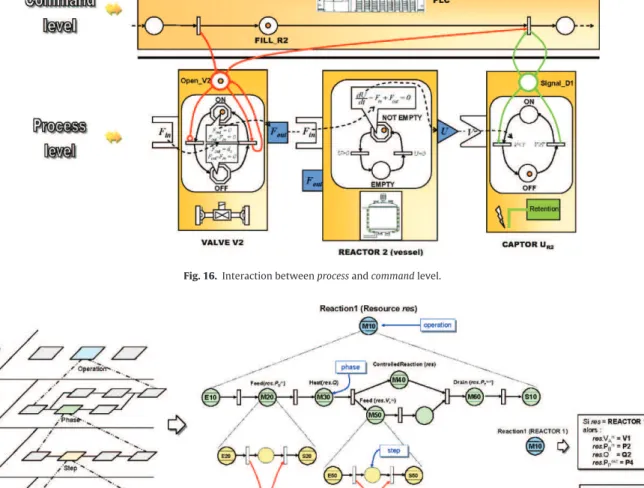

(Fig.17a),thecontrolrecipehasahierarchyonseverallevels
(pro-cedure,operation,phase,step,instruction,etc.).Toimplementthis structureintheODPNofthecommandlevel,thenotionof macro-placesisexploited.Itreplacesasequenceofplacesandtransitions relativetoanoperationoraphasebya singlemacro-place.This sequenceisthendelimitedbytwospecialplacesEandSbetween whichalltypesofplacesdefinedintheODPNformalismmayarise, includingothermacro-places(Fig.17b).
Atthehighestlevelofthehierarchy(theprocedure),a macro-placerepresentstheexecutionofaunitoperation.However,some operationsmaytakeplaceindifferentdevices.Forexample,inthe processshowninFig.5,theoperationcalledREACTION1canrunin theREACTOR1and/orREACTOR2.Forthisreason,anymacro-place canbesetwithanEquipmentUnitobject.Thisobjectrepresentsthe maindevice(forexample,thevesselofthereactor1)andallthe
actuatorsandcontrolequipment(here,thevalveV1,pumpsP2
andP4,heatingsystemQ2,engineM2andcaptorsUR1,TR1and
XPR1).Aninstanceofthisobjectdefinesaunitofequipmentand attributesofthisinstanceisthenusedtodefinethecommands orsignalsrequiredforeachsequence(Fig.17b).Thishierarchical structurefacilitatesthespecificationofthecontrolrecipeandthe setting-upofthesimulationmodelbytheuseofreusablesequences storedinmacro-place(seeFeedphaseinFig.17b).Anexampleof
recipecontrolisgivenin(Hétreux,Théry,&LeLann,2006).This functionalityisratherimportantsincethemodelofthecommand
leveliscompletelydisconnectedfromthemodelsoftheprocess
level.
6.1.2. Notionoftasktoken
The macro-place operation are parameterized by the used
devices(seeSection6.1.1)butalsobythecharacteristicsoftasksto perform.Forexample,areactorinwhichseveralreactionscantake placerequiresineachcasedifferentoperatingconditions (temper-ature,pressure,composition,etc.).Itisthecaseofthereactorcalled REACTOR2intheprocessshownonFig.5.Similarly,twotasks per-formingthesameoperationinthesameunitmaystillhavedifferent settings,especiallywhentheydependonthebatchsize.Toaddress theseissuesanddefinemoregenericoperationobjects,ataskobject hasbeenintroduced.Theattributesofataskobjectinclude,among othersthings:
•theearlieststartingdateofthetask, •thebatchsize,
•areferencetotheEquipmentUnitobjectallocatedtothistask, •areferencetotheoperationobjecttoperform,includingall
oper-ational parameters (temperature, pressure, composition, etc.) necessarytodefinetheconditionsandactionsofthesequence (stateeventsassociated withcontinuousvariables oftheDAE
Fig.16.Interactionbetweenprocessandcommandlevel.
Fig.17. Hierarchicalstructureofthecontrolrecipeusingmacro-places.

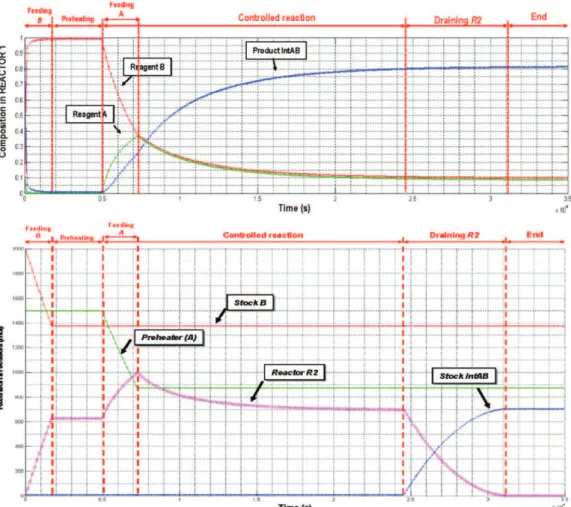

Fig.19.Simulationresultsoftask<REACTION1,REACTOR1,700mol>.
Ataskobjectthusdefinesthetriplet<Operation,EquipmentUnit, BatchSize>.However,thisinformationshouldbedisseminatedto instantiatetheconditionsandactionsofthetransitionsdispatched ontheODPNofanoperation.Forthisreason,thetaskobjectis asso-ciatedwithatokenobjectoftypeTaskToken(noted<T>).Whenan instanceofatoken<T>sensitizesatransition,thentheformal vari-ablesusedtodefinetheconditionsoractionsarereplacedbyits attributes(Fig.18).Finally,notethatthistokendoesnot material-izealotofmaterial,butaninformationalentityusedtolauncha task.Itcanthereforebeassimilatedtoanexecutionorder.
6.1.3. Simulationofaunitoperation
Toillustratetheabovediscussion,asimulationlimitedtothe task<REACTION1,REACTOR1,700mol>isexecuted.TheODPN
associatedwiththisoperationisshowninFig.18.Forthelaunchof asinglebatch(700molofIntAB),Fig.19aandbshowsrespectively theevolutionofthecompositioninREACTOR1andtheretention inthevariousconcerneddevices.
6.2. StructureoftheODPNofthecontrolrecipewithinthe procedurelevel
Foreachunitoperationopoftheprocedurecarriedoutonthe equipmentunitres(calledcouple<operation,EquipmentUnit>), a structurecalled“decisioncenter” isimplemented asshown in
Fig.18.Furthermore,aninstanceofTaskTokenobject<T>is cre-atedforeachtaskcorrespondingtothetriplet(op,res,size).This
ODPNmanageboththetemporalandtheresourceavailability:
•thetemporalaspectissupportedbyatimedplace(place Starting-DateinFig.18)formanagingthelaunchofeachtask.Thedelay
parameteroftheplaceisequaltothestartingdateofthetask carriedbythetoken<T>(P(<T>).delay←<T>.StartingDate).When thestartingdatehasexpired,thetokenisreleasedandmarksthe placededicatedtothemanagementofaqueue(placequeuein
Fig.18)whennecessary.
•amutexplaceisassociatedwitheachdisjunctiveresource(shared devicesbetweenoperationsornot)andmanageitsavailability (placeResAvailableinFig.18).Whenthisplaceisnotmarked,this indicatesthattheresourceisalreadyrequisitionedbyanother taskandpreventsthecrossingofthetransitioncalledstart.So,it avoidsthestartingofanewtaskbeforetheendoftheprevious one.
•ataskcanbestartedonlyafterensuringtheavailabilityof materi-als.Indeed,atthesimulationlevel,therealdurationofoperations canbeshorterorlongerthanthemeandelaytakenintoaccount attheschedulinglevel.Forthis,aconditionplacedonthe tran-sitionlocatedbeforetheoperationmacro-placeverifiesthatthe amountofmaterialsareequaltoorgreaterthantheproportion requiredforthebatchsizecarriedbythetoken.
Notealsothat:
•alltasksthatdonotsharethesameequipmentunitcan poten-tiallybeperformedinparallel,manytasksassociatedwiththe same couple <Operation, EquipmentUnit> can exist. In this context,thetimedplaceStartingDateissimplymarkedwitha numberoftoken<T>equaltothecorrespondingnumberoftasks.

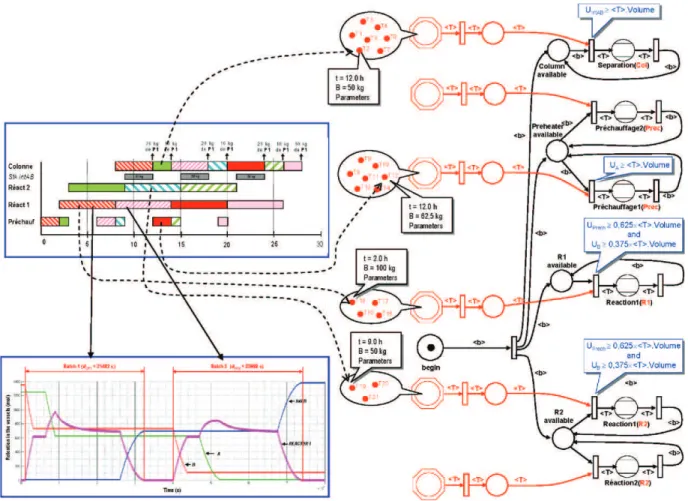

Fig.20.ODPNofthecontrolrecipe(procedurelevel).
•ataskTokenobject<T>representsthedatarelativetoasingletask. Itbecomesobsoletewhenthetaskiscompleted.Inotherwords, thesametokencannotbeusedfortwosuccessiveoperations (eveniftheywereidentical).Asaresult,noprecedence relation-shipappearsexplicitlyintheODPNofthecontrolrecipeatthe
procedurelevel.
6.3. Applicationontheprocessexample
BasedontheERTNshowninFig.6,theoptimizationmodule establishesaschedulingwiththeMILPmodelsolvedwith XPRESS-MP.Theparametersofthemathematicalmodelareinitializedwith estimatedaveragedurationsandlinearizedparameters.Giventhe characteristicsoftheprocessinFig.5,theschedulingofasingle productionorderequalto100kgofP1isshowninFig.20.
Aftertheschedulingstep,thesequenceoneachprocessingunit, thestartingdatesaswellasthenumberandthebatchsizesare transmittedtothesimulator.Eachtaskisinstantiatedand associ-atedwithataskTokenobject<T>.Fig.20showstheODPNofthe
controlrecipeattheprocedurelevelcorrespondingtotheERTNin
Fig.5instantiatedwiththeaforementionedscheduling.
The ODPNof thecontrol recipeis built byassembling a set ofdecisioncenter,eachoneassociatedwithacouple<Operation, EquipmentUnit>.Thus,operationscarriedoutbyseveral process-ingunitsmustbeduplicatedasitisdoneintheERTNformalism. ThiscaseconcernstheoperationREACTION1performedeitherin REACTOR1orREACTOR2.Inaddition,ifthesameresourceresis usedbyseveraloperationsopitheneachdecisioncenter
associ-atedwithacouple<opi,res>sharesthesamemutexplace(named
ResAvailable)which modelstheavailabilityoftheresourceres.
ThiscaseconcernsforexampleREACTOR2whichperformsboth
REACTION1andREACTION2.
Thesimulationisthenperformedbyfollowingtheproduction plansodefined.Performanceindicatorscanbecalculatedinorder toevaluatethequalityofthesolution.Fig.20showsthe succes-siveexecutionoftwobatchesofidenticalsizeinthesamedevice
(here, REACTOR1).Thecurves show thatthe durationsof each
batchare different(change infeedratedue toa gravity trans-fer).Thisexamplehighlightsthemodelinggap(modelsusedare differentbynature)existingbetweenthetwomodules (optimiza-tion/simulation)andtheneedtoprovidedecisionalautonomyto thesimulatorfor thestarting(ornot)ofproduction tasks.Asa result,schedules obtainedby simulationand thoseobtainedby optimizationarenotdirectlycomparable.
Severalcaseshavebeensolvedandgenerally,thesimulations
have been correctly completed. Nevertheless, some time
con-straints maynotbecompletelyfulfilled due inmostcases toa inaccurateestimationof theprocessingtimesatthescheduling level.Indeed,ifthedurationtakenintoaccountinthe optimiza-tionmodelisunderestimated,thesimulatorstartsthetaskatthe earliestwhentheallocatedresourceandtherequiredamountof materialareavailable.Nevertheless,futuretimeconstraintscould notbemet.Intheopposite,ifthedurationtakenintoaccountin theoptimizationmodelisoverestimated,thesimulatorisforcedto waittheexpiryofthescheduledstartingdate.Hereagain,future timeconstraintscannotbeguarantied.Fig.21illustratesthiscase. Infact,asestablishedin(Méndezetal.,2006),agapalwaysexists betweentheoryandpracticalduetothesimplifyingassumptions sometimesintroducedtomaketheproblemtractable.Thisisthe reasonwhythemodeliscalled“simplified”fortheschedulingpart, inoppositiontothe“detailed”modelforthesimulationpartwhich

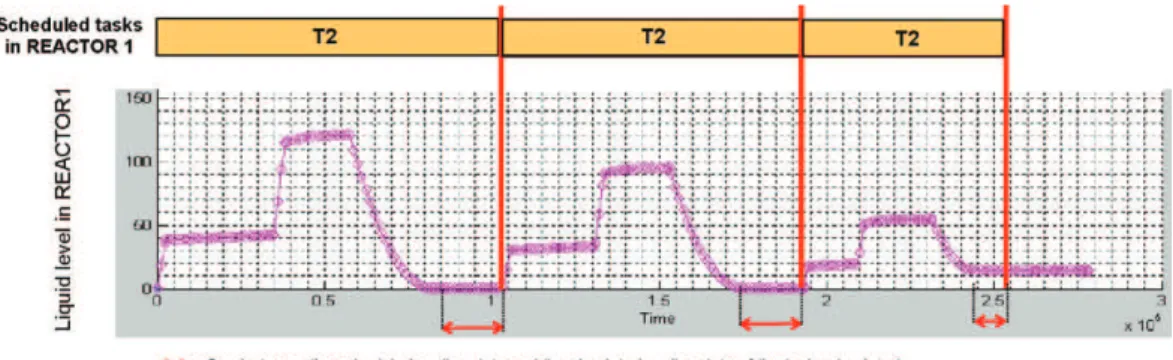

Fig.21.Simulationresultsfor3tasks<REACTION1,REACTOR1>withdifferentbatchsizes.
describesthephysicochemicalphenomenonbydifferential alge-braicequationssystems.Moreover,thisinducesthatthesearchof amathematicaloptimumofsimplifiedmodelscanseemuseless,in practice.Forvariousreasons,theimplementationofsuch schedul-ingisoftenlimitedwhenitisconfrontedwiththesimulationmodel oftheprocess.Inparticular,optimizationmodelareoften
estab-lishedundertheassumptionofconstant andknownprocessing
times.However,thisrepresentsasevererestrictiontowardthe sen-sitivityofcertainoperationstotheadjustmentsoftheoperating conditions.Thebatchcolumnisanexamplewheretheprocessing timedependsonseveralparameters:thequalityoftheinitialload, theheatingpolicyoftheboiler,therefluxpolicy,therackingside flows,thethermallosses,etc.Inaddition,thedurationofataskcan alsodependonthestateofthesystematagiventime.Forexample, thedurationofatransferbygravityisdependentontheretentionin thesourcetank.Inthesameway,theheatingdurationofaproduct dependsontheinitialtemperature,itselfbeingabletodependon thewaitingdurationoftheproductintheupstreamstoragetankif thermallossesexist.Finally,criterionisoftenreducedtoasubpart oftheoverallobjectivesconsideredbyend-users.So,ifa schedul-ingisonlya“good”solutionoftheproblem,itisnotadrawback andtheusercanadjustsomeparametersatthesimulationlevel. Forthesereasons,inthisprocedure,theoptimizationcalculations areoftenstoppedwhenafixedtimedelayoranintegralitygapis met.
Inordertorefinetheresults,theabovesimulationresultscanbe usedtoresetthedataofthemathematicalmodelandthusimprove theproductionplansobtainedthroughaniterativeprocedure.An anotherstrategyisthesimulationofeachoperationindependently forasetofparametersinordertoobtainedaccurateinitialdata fortheschedulingmodule.Nevertheless,itseemslikelythatthe simulatedplansaremoreeasilyexploitablebecausetheyarebased onamoreaccuraterepresentationoftherealphenomenaandcan providereferencepoints(temperature,pressure,composition,etc.) duringtheprogressionoftheinsituoperations.
7. Conclusion
Basedonobjectconcepts,PrODHySprovidessoftware compo-nentsforthemodelingandthedynamicsimulationofindustrial processes(Hétreuxetal.,2002;Hétreuxetal.,2003;Perretetal., 2004).Theimplementationofahighlevelformalism(Object Differ-entialPetriNet)associatedwithefficientnumericalmethods(Gear, 1971)hasledtothedevelopmentofahybriddynamicsimulator numericallyrobust.Inordertodealefficientlywiththesimulation ofbatchprocess,thispaperpresentsapackagewhoseroleistobuild automaticallyoptimizedproductionscenariosthatshouldrunthe simulator.Forthis,severalkeyissueshavebeenaddressed.First,it hasbeenintroducedtheERTNgraphicalformalismthatmodelsthe maincharacteristicsofaprocess.Thisformalismisusedinthe
soft-wareProSchedGeneratordesignedtogeneratetheinputparameters oftheschedulingmodel.Thisgenericmathematicalmodel(MILP) isbasedonacontinuoustimeformulationcalledUnit-SpecificTime Event.Thismodulecalculatesallinputdatausefultothesimulation model.Secondly,theinterfacebetweentheoptimizationmodeland thesimulationmodelhasbeenestablished.
For this, the ODPN of the control recipe is structured into
several levels by using parameterized macro-places.Moreover,
informationassociated witheach taskisdistributed throughout thenetworkthankstotasktokenobject.
Currently,theeffectivenessofthisframeworkhasbeenproved andseveralstudiesonbatchprocesseshavebeenconductedwith success.Nevertheless,itmight beinterestingtotestother opti-mizationmodelstoimprovethequalityoftheschedulingobtained inthefirststepoftheprocedure.Especially,manyrobust optimiza-tiontechniquescanbeappliedinordertoexplicitlymodelsystem uncertaintyandgenerateaschedulewhichisnotonlyfeasiblefor thenominalsystemconditionsbutalsorobustwhenconsidering thedistributionoftheunknownsystemparameters(Lin,Janak,& Floudas,2004;Janak,Lin,&Floudas,2007;Shaik&Floudas,2009). To conclude, note that this procedure is included as a part
ofa moregeneralmethoddedicatedtotheschedulingofbatch
processes.Thefundamentalprincipleistosupposethatan “approx-imate”solution(intermofbehavior)providedbyanoptimization modelwithareducedcomputationaleffort,iscompensatedbya finermodelingoftheprocesscarriedoutatthesimulationlevel. Thisapproachshouldmakemorerobusttheproductionplansand facilitatesthephysicochemicalanalysisofphenomena.However, inordertovalidatethisapproachandevaluatequantitativelyits effectiveness,severalmodulesarecurrentlyindevelopment.
References
AghaM.(2009).Integratedmanagementofenergyandproduction:schedulingof batchprocessesandCHPplants,ThèsedeDoctorat,INPdeToulouse,France. Burkard,R.E.,&Hatzl,J.(2005).Review,extensionsandcomputationalcomparison
ofMILPformulationsforschedulingofbatchprocesses.ComputersandChemical Engineering,29,1752–1769.
FabreF.(2009).Conduiteorientéeordonnancementd’unsimulateurdynamique hybride: Application aux procédés discontinus, Thèse de Doctorat, INP, Toulouse,France.
Floudas,C.A.,&Lin,X.(2004).Continuous-timeversusdiscrete-timeapproachesfor schedulingofchemicalprocesses:areview.ComputersandChemicalEngineering, 28,2109–2129.
GearC.W.(1971),TheSimultaneousNumericalSolutionofDifferential-Algebraic Equations,IEEETransactiononCircuitTheory,CT18(1),Ed.AcademicPress. Ierapetritou,M.G.,&Floudas,C.A.(1998).Effectivecontinuous-timeformulationfor
short-termscheduling:1.Multipurpousebatchprocesses.Industrialand Engi-neeringChemistryResearch,37,4341.
Hétreux,G.,Théry,R.,Perret,J.,Lelann,J.M.,&Joulia,X.(2002).Bibliothèque orientée-objetpourlasimulationdynamiquedesprocédés:architectureetmiseenoeuvre.
Toulouse:CongrèsSIMO.
Hétreux,G.,Perret,J.,&LeLann,J.M.(2003).Objecthybridformalismformodelling andsimulationofchemicalprocesses.InADHS’03Saint-Malo,France,
Hétreux,G.,Perret,J.,&LeLann,J.M.(2004).Composantbasedapproachfor sim-ulationofdynamichybridsystems.InConferenceonConceptualModelingand Simulation(CMS’04)Genoa,Italy.
Hétreux, G.,Théry,R.,& LeLann, J.M.(2006).Outild’aideà ladécisionpour l’ordonnancementdesprocédéssemi-continus:lenoyaudesimulationdynamique hybride.Toulouse,France:CongrèsSIMO.
Hétreux,G.,Thery,R.,Olivier,N.,&Le,Lann.(2007).Delasimulationdynamique hybrideverslaconduitedeprocédésbatchetsemi-continus.JournalEuropéen desSystèmesAutomatisés(J.E.S.A)EditionLAVOISIER,41(5),585–616.
Janak,S.L.,Lin,X.,&Floudas,C.A.(2004).EnhancedContinuous-timeunit-specific event-basedformulationforshort-termschedulingofmultipurposebatch pro-cesses:resourceconstraintsandmixedstoragepolicies.IndustrialEngineering andChemicalResearch,43(10),2516–2533.
Janak,S.L.,Lin,X.,&Floudas,C.A.(2007).Anewrobustoptimizationapproachfor schedulingunderuncertainty:II.Uncertaintywithknownprobability distribu-tion.ComputersandChemicalEngineering,31,171–195.
Jourda,L.,Joulia,X.,&Koehret,B.(1996).IntroducingATOM,theapplied ther-modynamicobject-orientedmodel.ComputersandChemicalEngineering,20A,
S157–S164.
Kallrath,J.(2002).PlanningandSchedulingintheprocessindustry.ORSpectrum,24,
219–250.
Kondili,E.,Pantelides,C.C.,&etSargent,R.W.H.(1993).Ageneralalgorithmfor short-termschedulingofbatchoperations–IMILPformulation.Computersand ChemicalEngineering,17–2,211–227.
Lin,X.,Janak,S.L.,&Floudas,C.A.(2004).Anewrobustoptimizationapproachfor schedulingunderuncertainty:I.Boundeduncertainty.ComputersandChemical Engineering,28,1069–1085.
Maravelias,C.T.,&Grossmann,I.E.(2003).Minimizationofthemakespanwitha discrete-timeState-Tasknetworkformulation.IndustrialandEngineering Chem-istryResearch,42,6252–6257.
Méndez,C.A.,Cerdá,J.,Grossmann,I.E.,Harjunkoski,I.,&Fahl,M.(2006). State-of-the-artreviewofoptimizationmethodsforshort-termschedulingofbatch processes.ComputersandChemicalEngineering,30(6–7),913–946.
Moyse, A. (2000), Odysseo: plate-forme orientée-objet pour la simulation dynamiquedesprocédés.ThèsedeDoctorat,INPdeToulouse,France. Olivier-MagetN.(2007).Surveillancedessystèmesdynamiqueshybrides:
applica-tionauxprocédés,ThèsedeDoctorat,INPdeToulouse,France.
PantelidesC.C.(1994).Unifiedframeworkfortheoptimalprocessplanningand scheduling,CAHEPublications,ProceedingsofthesecondConferenceon Founda-tionsofComputerAidedOperations,pp.253–274.
PerretJ.(2003),IntégrationdesRéseauxdePetriDifférentielsàObjetsdansune plateformedesimulationdynamiquehybride:applicationauxprocédés indus-triels,ThèsedeDoctorat,INP,Toulouse,France.
Perret,J.,Hétreux,G.,&LeLann,J.M.(2004).Integrationofanobjectformalism withinahybriddynamicsimulationenvironment.ControlEngineeringPractice (Elsevier),12/10,1211–1223.
SargousseA.(1999).Noyaunumériqueorientée-objetdédiéàlasimulationdes systèmesdynamiqueshybrides,ThèsedeDoctorat,INPdeToulouse,France. ShaikM.A.,JanakS.L.etFloudasC.A.(2005),Continuous-TimeModelsfor
Short-TermSchedulinginMultipurposeBatchPlants:aComparativeStudy,Chemical Engineering,PrincetonUniversity,Princeton,NJ08540.
Shaik,M.A.,&Floudas,C.A.(2009).NovelUnifiedModelingApproachforShort-Term Scheduling.IndustrialandEngineeringChemistryResearch,48,2947–2964. Zaytoon,J.(2001).Systèmesdynamiqueshybrides.HERMESSciencespublications.
